18:34:00 EDT Sat 18 May 2024
Enter Symbol
or Name
USA
CA



Torex Gold Resources Inc (2)
Symbol TXG
Shares Issued 85,968,582
Close 2024-04-30 C$ 19.40
Market Cap C$ 1,667,790,491
Recent Sedar Documents

Torex to produce concentrate at Media Luna by year-end

2024-04-30 18:19 ET - News Release

Ms. Jody Kuzenko reports

TOREX GOLD PROVIDES Q1 2024 UPDATE ON MEDIA LUNA PROJECT

Torex Gold Resources Inc. has provided its first quarter 2024 update on the development of its Media Luna project. Unless otherwise stated, progress and milestones referenced in this press release are as of March 31, 2024. (All amounts are expressed in U.S. dollars unless otherwise stated.)

Jody Kuzenko, president and chief executive officer of Torex, stated: "We continue to demonstrate our ability to deliver excellence in project execution. With the construction period now crossing the two-year mark, Media Luna remains on track for first copper concentrate production before year-end and commercial production in early 2025, the combination of which are expected to result in a return to positive free cash flow towards the middle of next year.

"Solid progress was made during the first quarter, with engineering activities now 91 per cent complete, procurement activities 78 per cent complete and the overall project almost 70 per cent complete. Underground construction and development sat at 64 per cent complete, with vertical and lateral development tracking to plan. In addition, the construction of ore/waste-handling systems is advancing well, and 78 per cent of Guajes tunnel conveyor tables are now installed. We continue to make steady gains on surface construction, with two-thirds of concrete now poured, steel erection progressing, copper flotation cells being installed and the sediment/decant ponds completed.

"As at quarter-end, 95 per cent of the upfront capital expenditures had been committed, including 71 per cent incurred. To date, capital expenditures have tracked reasonably well to the initial budget of $874.5-million, noting again that the stronger Mexican peso remains a headwind to contend with. Quarterly expenditures are expected to remain above $100-million through [third quarter] 2024 before declining in [fourth quarter] 2024 as Media Luna nears completion and commercial production is subsequently declared.

"With available liquidity of more than $400-million as at the end of March, our liquidity position is more than sufficient to fund the $257-million of capital expenditures remaining on Media Luna while meeting our objective to maintain at least $100-million of liquidity on the balance sheet. With production and costs tracking to full-year 2024 guidance, together with the strong gold price, our funding position is expected to strengthen even further through the remainder of the year.

"The successful completion of Media Luna, combined with ongoing exploration success at Morelos, our track record of consistent and reliable production, and the transition back to positive free cash flow in 2025, will provide a world-class platform to drive long-term shareholder value as we grow our operations in Mexico and beyond."

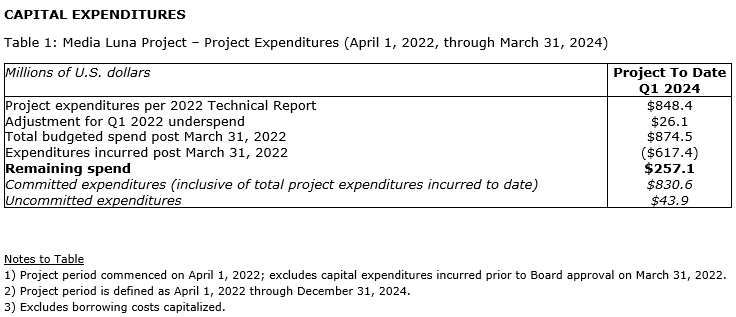

During first quarter 2024, $126.4-million was invested in the project. Expenditures are expected to remain above $100-million through third quarter of this year, before declining in fourth quarter, as the project nears completion. As at quarter-end, $830.6-million of expenditures had been committed (95 per cent), including $617.4-million incurred (71 per cent). There has been no change to full-year guidance of $350-million to $400-million on project capital expenditures.

As reported previously, the company has entered into a series of zero-cost collars to hedge against changes in foreign exchange rates of the Mexican peso. The average floor price of the collars is 17.38 Mexican pesos per U.S. dollar, and the average ceiling price is 20.0, with the collars covering the remaining project period (through December, 2024). Approximately 45 per cent of the remaining expenditures are expected to be denominated in pesos, and the level hedged represents approximately 38 per cent of the peso-denominated expenditures. The initial upfront capital cost of developing Media Luna assumed a Mexican peso of 20.0, which, weighted by quarterly expenditures, has averaged approximately 18.0 since the project commenced on April 1, 2022. The peso is currently trading around 17.0.

Project completion

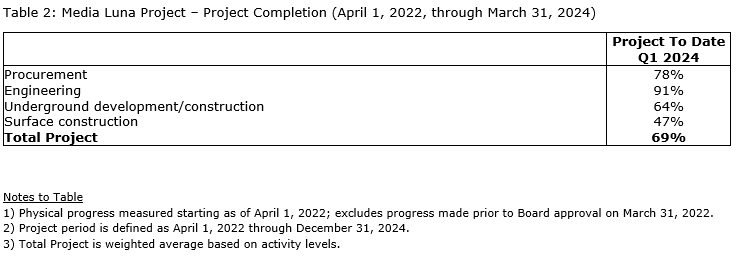

As at quarter-end, development of Media Luna was tracking to plan with the project 69 per cent complete, up from 60 per cent at the start of the quarter. Detailed engineering is at the 91-per-cent completion mark while procurement is 78 per cent complete. Underground development/construction and surface construction are advancing nicely with completion levels at 64 per cent and 47 per cent, respectively. Based on the current schedule, the tie-in of upgrades to the processing plant is still on track to occur over a four-week period during fourth quarter 2024, which will allow for commissioning and first concentrate production in late 2024 and commercial production in early 2025.

Engineering

As engineering works near completion, both surface and underground teams continue to focus on electrical deliverables, such as electrical schematics, and are working closely with vendors to expedite purchase orders and compress delivery timelines where possible. For underground, drawings were issued for the main garage and service water pump station. On surface, steel fabrication drawings were issued for the copper concentrate storage and loadout, and fabrication drawings for paste plant steel were released for fabrication.

Procurement

Steady progress was made on procurement during the quarter, which is 78 per cent complete from 63 per cent at the start of first quarter. Purchase orders were placed for pumps, HDPE pipe, fire protection hydrants and accessories, the sampling building for copper concentrate, the underground LTE system and instrumentation, and control panels for the 230-kilovolt power system. Contracts have been signed for the Guajes conveyor belt splicing, 230-kilovolt substation structural and electrical works, and 230-kilovolt switch yard and transmission line installation, as well as the installation of HDPE for freshwater and firewater systems.

During the quarter, the ore and waste transfer conveyors, west adit main fans, vibrating screens, rock breakers and grizzly steel, and 15-kilovolt power cables were delivered to site for the underground installation and construction. Deliveries to site for the surface infrastructure included: cleaner flotation cells, PLC panels, agitators, flocculant systems, copper concentrate filter, froth pumps, carbon steel pipe, and mechanical and structural steel. Approximately 3,600 metres of rubber-lined pipe for the slurry line from El Limon Guajes to the paste plant has been delivered to site. Importantly, the paste plant filter presses have completed testing and are expected to be delivered in early August.

Underground development and construction

As of the end of quarter, 94 per cent of bolts for the Guajes conveyor hanging sections had been placed, and 78 per cent of the Guajes conveyor belt tables had been installed. Conveyor belt segments have arrived at site, and belt splicing (flaking) has started in anticipation of installation commencing mid-second quarter, well ahead of commissioning in August. Additionally, work progressed in the Guajes tunnel to prepare for the installation of various mine services following the conveyor table installation. Breakthrough also occurred in two of the ore/waste passes, as well as ore bins 1 and 2, enabling preparation for steel installation at the ore bin tops and bottoms. Work proceeded to excavate the cone for the grizzly at the first rock breaker station. The pilot hole for the 87-metre ventilation raise was completed, and reaming began in April.

In-mine development continued to advance steadily. The first charging bays for the Sandvik production equipment and Rokion/MacLean support equipment were excavated, with the installation of the charging equipment completed in April. As of the end of the quarter, there were 36 active headings, including 33 in Media Luna Lower (the area of initial production) and three in Media Luna Upper.

Surface construction

Surface construction is progressing to plan, with 67 per cent of the planned concrete for the project now poured. On the north side of the Balsas River, significant progress was made on the installation of the flotation cells at the processing plant. Installation of the Guajes tailings thickener has commenced. Piping installation is under way in the water treatment area and at the processing plant between the grinding and flotation circuits. A new trash screen and a discharge chute were installed at the grinding area, and mechanical and piping tie-ins were completed during planned maintenance downtime in April. Construction of the steel support towers at the 230-kilovolt substation has commenced as concrete works were substantially completed in first quarter as planned. The e-house for the Guajes conveyor has been placed onto concrete supports at the head station located outside of the Guajes tunnel.

On the south side of the Balsas River, all concrete for the paste plant thickener area has been poured, with the balance of the plant concrete to be completed during the second quarter to facilitate the start of steel erection in May. Liner has been installed upstream on both the sediment and decant ponds, and backfill around the perimeter was completed in April, finalizing these works. Deposition of waste rock into the new west waste rock storage facility has begun.

Operational readiness

In parallel with development and construction activities, the surface and underground operational readiness strategy continues to advance as planned. Operational readiness teams are accountable for ensuring that processes and systems for all new work areas are established and ready in advance of the handover from the project team to operations. This includes work force transition planning and training, developing the operating strategy (including all standard operating procedures), and maintenance plans for all fixed and mobile equipment, blend and feed strategies, detailed commissioning plans, first fills, concentrate shipment logistics, and all other requirements to ensure a smooth ramp-up. Training for the transition from open-pit to underground miners is well under way, and the first graduates from the program have joined the underground mine development team. The first battery electric jumbo drill operation training commenced in January in addition to training of long-hole drill and scoop operators. Recruitment from local communities to fill vacant underground positions is also ramping up. Systems have been put in place for technical training progression across various levels of theory, simulator training and field training. Negotiations are under way with various haulage companies for copper concentrate transport to port distribution facilities. The company is in the final stages of settling the commercial terms for the offtake agreements with a mix of traders and smelters. Payables are tracking in line with that which was incorporated into the most recent technical report dated effective March 16, 2022, and filed on March 31, 2022.

Project execution plan

Based on progress made during Q1 2024 and a detailed review of both the surface and underground schedules completed late in the quarter, the overall project end dates are unchanged compared with the prior plan outlined within the last Media Luna update press release published on Feb. 7, 2024, with only modest adjustments to interim activities in the overall schedule.

In terms of the overall project schedule, the company continues to actively monitor the delivery dates for long-lead critical items to ensure vendors meet their delivery obligations. Electrical equipment, specifically, remains a focus to manage schedule risk given the long-lead times for delivery of this equipment (e-houses and switchgear).

The current project plan relative to the company's technical report reflects the company's estimates for the completion of key project deliverables. These updated deliverables have not impacted the overall project schedule given the original plan had assumed the potential for schedule adjustments and the possibility for supply chain disruptions.

More detail on the Media Luna project, including the feasibility study results, can be found in the technical report.

About Torex Gold Resources Inc.

Torex is an intermediate gold producer based in Canada, engaged in the exploration, development and operation of its 100-per-cent-owned Morelos property, an area of 29,000 hectares in the highly prospective Guerrero gold belt located 180 kilometres southwest of Mexico City. The company's principal asset is the Morelos complex, which includes El Limon Guajes (ELG) mine complex, the Media Luna project, a processing plant and related infrastructure. Commercial production from the Morelos complex commenced on April 1, 2016, and an updated technical report for the Morelos complex was released in March, 2022. Torex's key strategic objectives are to integrate and optimize its Morelos property, deliver Media Luna to full production, increase reserves and resources, retain and attract best industry talent, and build on environmental, social and governance excellence.

Qualified person

The technical and scientific information in this press release has been reviewed and approved by Dave Stefanuto, PEng, executive vice-president, technical services and capital projects, of the company, and a qualified person under National Instrument 43-101.

We seek Safe Harbor.

© 2024 Canjex Publishing Ltd. All rights reserved.
